The Project

Scope of Work

The project will be completed over two construction seasons. Work under sections 1 and 3 will maintain one lane of traffic under temporary traffic control, while work under section 2 will be constructed under a full road closure to allow for efficient completion of extensive underground and surface works. Driveways and pedestrian access will be managed by temporary re-routing as required throughout the stages of construction. Project completion date is March 2028.

Section 1

Toronto Street to Cumberland Street (Early Spring 2026 to late fall)

Work involves removing and replacing of existing asphalt, curb, sidewalk and boulevard, installing and commissioning new watermain, storm water management, staged construction of a roundabout at Toronto Street. One lane of traffic will be maintained with possible detours during paving operations along with coordinated temporary driveway/sidewalk closures to maintain one-lane of traffic and landscaping.

Section 3

Lorne Street to East of Highway 23 (Early Spring 2026 to late fall)

Work involves removing and replacing existing asphalt, curb, sidewalk and boulevard, constructing a new sanitary sewer from Minto Road to the west project limit, installing and commissioning a new watermain, and constructing a roundabout at Minto Road.

Section 2

Cumberland Street to Lorne Street (Early Spring 2027 to late fall)

Work involves removing and replacing existing asphalt, curb, sidewalk and boulevard, constructing a new sanitary sewer from Henry Street to Lorne Street, installing and commissioning a new watermain, adding decorative street lighting and traffic signals at William with a pedestrian crossover between Cumberland Street and Wellington Road 5 (Whites Road).

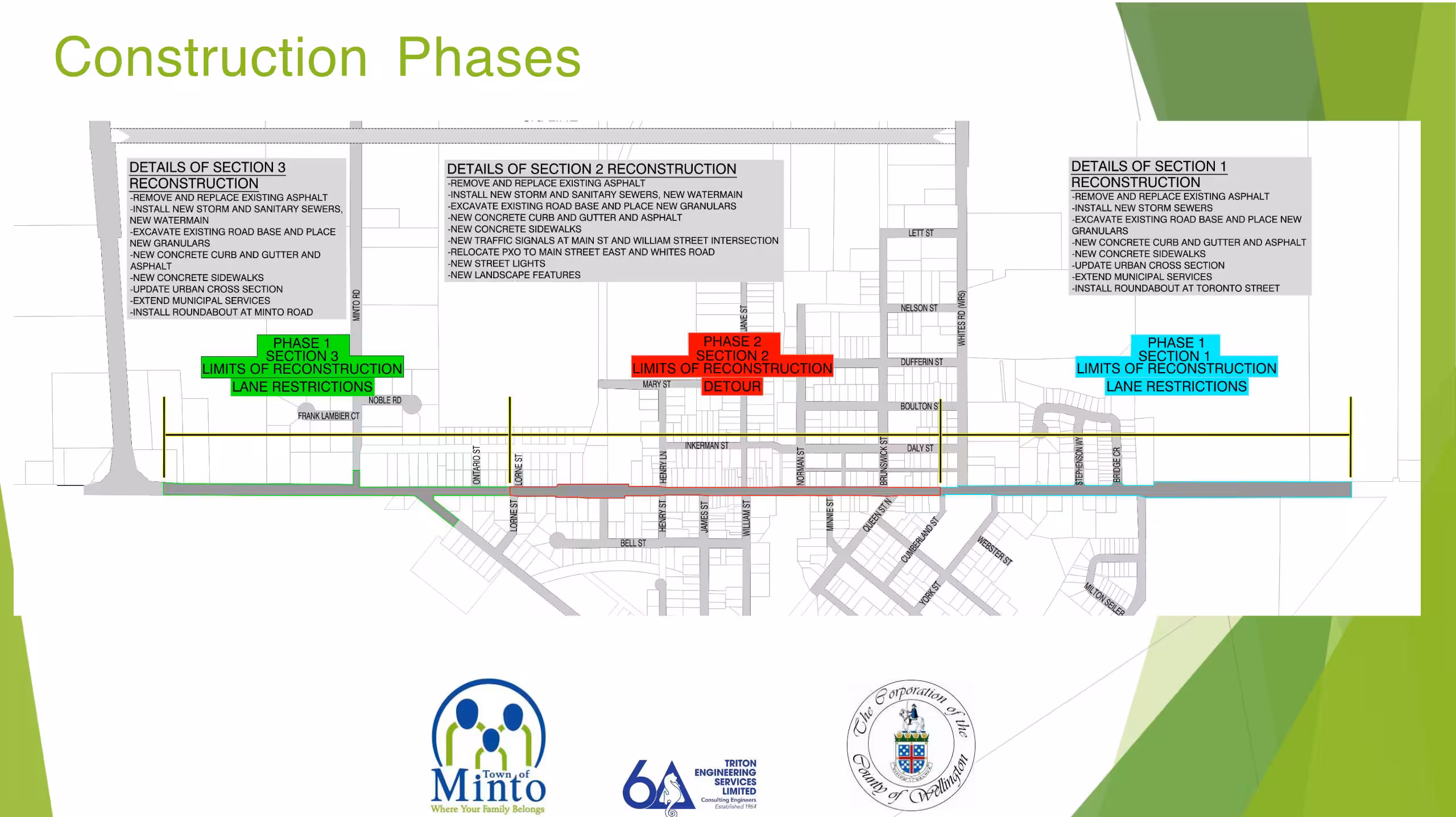

Construction Phases and Project Schedule

Construction Kick‑Off Presentation

Kick-Off Presentation slideshow

Here are the slides used in the above presentation.
